Splitting cuts one booking into two separate bookings at a date you choose. Use it when plans change partway through, for example when the second half moves to someone else, or needs different hours. You can then edit each part on its own.
Administrators and Scheduling Managers can split bookings: only they get the right-click menu on the schedule. A Scheduling Manager who isn't an Administrator must be a member of the booking's project. The booked person must still have the Scheduling User role and be a member of the project.
Split a booking

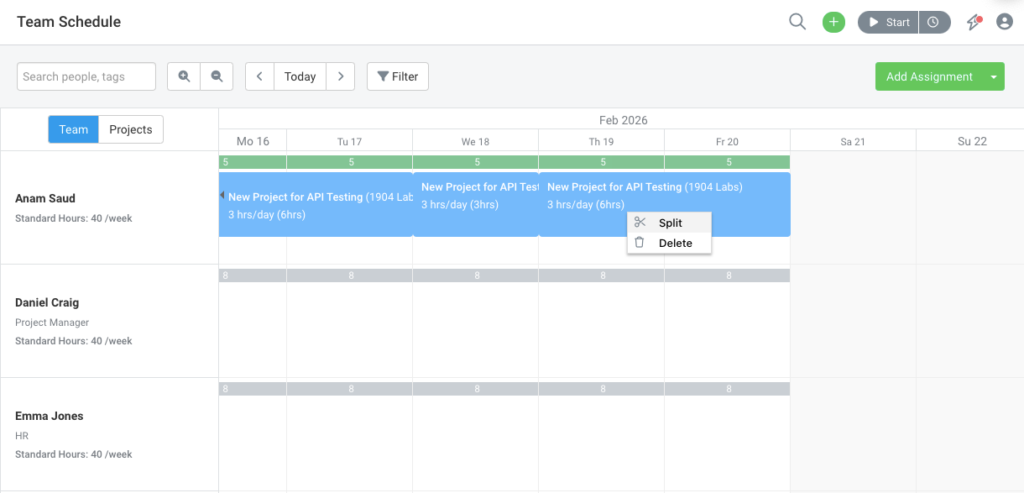

On the Team Schedule or Project Schedule tab, right-click the booking on the day where the second part should start.

Choose Split.

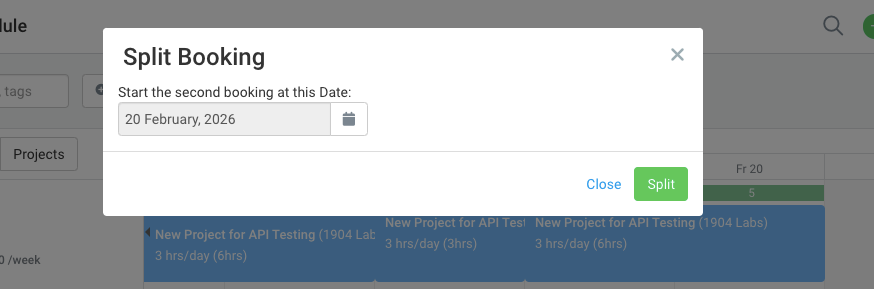

In the Split Booking popup, check the date under Start the second booking at this Date. It starts as the day you right-clicked. You can pick any day from the booking's second day to its last day.

Click Split.
Only bookings longer than one day can be split. For a one-day booking, Avaza says it "is only 1 day long so cannot be split". Splitting has no keyboard shortcut or drag gesture: use the right-click menu. Leave bookings can be split the same way.
What each part keeps
- Dates: the first part runs from the original start date to the day before your split date. The second part runs from the split date to the original end date.
- Details: both parts keep the project (or leave type), timesheet category, task, notes, hours per day, start and end times, and the Schedule on days off setting.
- Hours: each part's total is worked out again from its own days, so together they add up to the original total.
- Days off: unless the booking has Schedule on days off ticked, neither part starts or ends on a day off. The first part ends on the last working day before the split date, and the second part starts on the first working day from the split date. If a part would have no working days, the split is refused.
- Time already logged: days that were already turned into time stay marked in both parts, so they don't come back on the Timesheets page.
- Task link: both parts stay linked to the task. The task then has two bookings, so its dates and assignee stop syncing with them. See linking bookings to tasks.
After splitting, click either part to change its person, hours or dates in Edit scheduled time, or drag it. There's no undo. To join the parts again, delete one, then open the other and change its dates.
Recurring bookings
On an occurrence of a recurring booking, Split asks "How would you like to split?":

- Split Recurring Sequence makes two series. The second starts on the occurrence you pick.
- Split Occurrence from Recurring Series takes the clicked occurrence out as a stand-alone booking. The occurrences before and after it carry on as series. If only one is left on a side, it becomes a stand-alone booking too.
- Split Occurrence appears for occurrences of two days or more. It takes the occurrence out of the series, then splits it in two at the date you pick.
A split series keeps its pattern on each side. To edit, move or delete occurrences instead, see recurring schedule bookings.
